Capital Projects Update

Heavy equipment digging in dirt

Fall 2024 Update

Western Corridor Pipeline

Approximately 40% of the pipe has been installed as of the end of September. Two pipe-laying crews continue to work in separate locations, and boring continues on the East side of the project. Other active work includes rock removal and concrete placement for valve vaults. Work in the most developed section of the project through Lowell is predicted to begin in the coming months.

Western Corridor Pump Station

Half of the concrete slab for the Pump Station has been poured and the other half should be completed in early November. All the structural steel for the pre-engineered metal building is on-site and is ready to be installed once the slab has been cured. Work on West Miller Road is near substantial completion and the road is now fully back open for traffic with new asphalt pavement.




Summer 2024 Update

Western Corridor Pipeline

There are now two pipe-laying crews working on the project to help speed up progress. One crew began working just east of Lincoln Street in Lowell and is heading eastward toward Hwy 265. The other crew started near the pump station and is making their way eastward toward Spring Creek. There is also a boring crew working on the road crossings, and they have nearly completed the boring under Dixieland Road in Lowell.

Western Corridor Pump Station

Work continues on the underground electrical conduit to supply power to all pumps and equipment in the pump station and should be completed in the next couple of weeks. After that, the building slab will be constructed. The 60” header pipe has been installed. This is the first good visual of what the project’s purpose is, and where the pipeline will join into the pump station. Improvements to Miller Road are also nearing completion, hopefully before school starts. Carroll Electric is also nearing completion of a new sub-station that will provide primary power to the site.

Solar Project

At their July 18 monthly meeting, the BWD Board of Directors authorized management to finalize the engineering, procurement, and construction (EPC) contract with NextEra Energy for construction of a 4.99-MW solar generating facility. The project will be on the District’s property at the northwest corner of Primrose Road and Nail Avenue adjacent to the treatment facility, and the completion date has been updated to the 2nd quarter of 2025. The solar facility is projected to provide approximately 20% of BWD’s current electricity needs and will reduce its annual electricity bills by over $700,000.


Spring 2024 Update

Western Corridor Pipeline

Approximately half of the 60-inch diameter steel pipe to be installed has now been delivered and strung along the pipeline alignment, mostly on the East side of Interstate 49. Pipe installation recently began by the JB Hunt campus with a 400-foot-long test section to verify installation procedures. Pipe installation will proceed Eastward to BWD’s water treatment facility with a second pipe laying crew beginning work on the West side of the Interstate in the coming year. Boring under roadways will begin soon starting at Dixieland Street in Lowell.



Western Corridor Pump Station

Things are picking up at the pump station. Pipes for connecting our customer cities to the western corridor pipeline have been installed. The pump station slab foundation is being completed and electrical conduit has been placed. The 60-inch suction header pipe will arrive on site soon, and the pads for the backup generators are nearing completion. Things will start taking shape this summer when the foundations are poured, and the building is constructed during the fall.


Winter 2024 Update

Western Corridor Pipeline

Trenching for the 60-inch steel pipeline started in December. The trencher started near Interstate 49 just north of the JB Hunt campus and proceeded eastward across South Dixieland Street towards HWY 71. Trenching is expected to start west of Interstate 49 along the north side of HWY 612 in February. The casing pipe for a few of the road crossings has been delivered, and major shipments of the 60-inch diameter steel pipe should start to be strung along the alignment in late February.



Western Corridor Pump Station

Because of the holiday season and winter weather, things have been moving a little slower lately at the pump station. However, there has been some progress on damp proofing and backfilling the concrete trench structure and getting the generator pads constructed. Pipes and other materials are also beginning to arrive at the site in preparation for constructing the concrete slabs in the pump station building.


November 2023 Update

Western Corridor Pipeline

Thalle Construction, the contractor for the Western Corridor Pipeline, expects the first major piece of equipment, which is a very large trencher, to arrive in November. The trencher will be used to “pre-trench” rock areas along the route, which will break up the hard rock and make the actual pipe laying process go faster. Large excavators will be used to lay the pipe beginning in early 2024. Manufacturing of the 60”-diameter steel water pipes will begin in November, and pipe deliveries are expected to begin in December.



BWD Solar Park I

BWD and NextEra met with Carroll Electric Cooperative Corporation (CECC) in October to discuss the interconnection of the solar project. This meeting resulted in a proposed interconnection at CECC’s substation, and CECC is working on a cost estimate for this. NextEra has completed various site studies to enable them to move forward with development of an Engineering, Procurement, and Construction (EPC) proposal, which is expected in early December. BWD will review the EPC proposal, and if it is acceptable, both parties will execute in early 2024 with construction set to be completed by December 31, 2024.



Western Corridor Pump Station

Things are beginning to really take shape at the site, and construction is progressing according to schedule. Most of the major earthwork for the pump station has been completed, as well as the concrete trench structure that will house the end of the new 60” pipeline. Carroll Electric Cooperative has also mobilized close to the site and begun construction of a new substation that will help power the pump station.


August 2023 Update

Western Corridor Pipeline

Thalle Construction, who is the contractor for the Western Corridor Pipeline, has marked the roadway and railway crossings, and most of the clearing is complete. The pipe for the project is scheduled to arrive in November, but Thalle plans to begin trenching some of the rock areas in late summer or early fall to break up the rock and make actual pipe laying activities go faster once pipe lay- ing is underway. The project is being funded with State Revolving Funds (SRF), and two reimbursements have been made by the state for project legal and engineering expenses, as well as some of Crossland’s initial startup costs.



BWD Solar Park I

BWD and NextEra executed the Build Transfer Agreement (BTA) on June 30, 2023. The BTA establishes the terms and conditions for the development phase of the project, which includes such items as site investigation, permitting, and preliminary design plans. Per the BTA, the development tasks shall be completed before December 31, 2023. After completion of the BTA work, NextEra will use their findings to develop an Engineering, Procurement, and Construction (EPC) agreement that includes design and final pricing. BWD will review the EPC, and if it is acceptable, both parties will execute in early 2024.



Western Corridor Pump Station

Construction Manager, Crossland Heavy Contractors, has mobilized, started site work, and installed stormwater pollution prevention measures. They have established their construction office on site and are working on equipment submittals. Long lead items have been ordered and significant construction activities are expected to start this month. The pump station is being funded from BWD’s operations with no financing from outside sources.

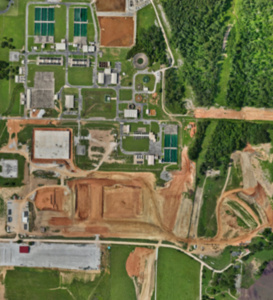

Dirt work begins for the Western Corridor Pump Station.




May 2023 Update

Western Corridor Pipeline

At their April 20th monthly meeting, the Beaver Water District (BWD) Board of Directors approved the contract with Thalle Construction for the Western Corridor Pipeline. The contract price is $66.8 million for construction of the 60-inch diameter pipeline that will carry treated water 40,000 feet westward to the planned Western Corridor Pump Station. The Notice to Proceed is expected to be in May, with a planned completion date at the end of 2025. Olsson, who designed the pipeline, will be providing construction-phase engineering and observation services.



Western Corridor Pump Station

At the April meeting, the BWD Board of Directors also approved an amendment to the Western Corridor Pump Station contract with our construction manager, Crossland Heavy Contractors, which authorizes them to move forward with construction at a Guaranteed Maximum Price (GMP) of $38.37 million. The pump station will initially house three pumps each for Springdale and Fayetteville, with the ability to add one additional pump for those cities and four future pumps each for Bentonville and Rogers. The completion date for the pump station is also the end of 2025. Black & Veatch designed the pump station and will be providing the construction-phase engineering and observation services.



BWD Solar Park I

The district is working with legal counsel and NextEra on finalizing contracts for our planned 5-MW Solar Park I project and anticipate requesting board execution of the contracts at the May meeting. Design and permitting is planned for the remainder of 2023, with construction to be completed by December 31, 2024. The estimated cost of the project is approximately $10.5 million and is anticipated to supply 15 – 20% of BWD’s electricity, reducing annual electricity bills by over $700,000 per year.
